What Is a User Requirement Specification (URS)? How to Write and Manage One

Chapters

Chapter 2: What Is a User Requirement Specification (URS)? How to Write and Manage One

Chapters

What Is a User Requirement Specification (URS)? How to Write and Manage One

A user requirement specification (URS) gives every team the same interpretation of what a system needs to do, and gives every auditor a single thread to trace from user need through design, test, and validation. When it’s written before anyone picks a vendor or writes a line of code, it protects the project from scope drift, misaligned designs, and preventable audit findings.

This guide covers what a URS is, how it differs from other specification documents, how to write requirements that hold up to regulatory scrutiny, and how to manage the URS after it’s baselined.

What Is a User Requirement Specification?

A user requirement specification (URS) defines what a system must do, based on business needs and written without locking in any specific technology. It captures user needs and intended use before the engineering team decides how to build anything, and a properly written URS stays valid regardless of which vendor or platform you choose.

The URS carries formal standing in regulated work. Under Good Manufacturing Practice (GMP) Annex 11, user requirements must remain traceable throughout the lifecycle, meaning you can follow each requirement from its origin through design, testing, and final validation. GAMP 5 guidance uses the URS as the reference point for Performance Qualification (PQ), where teams prove the finished system actually meets user needs.

Where the URS Fits in the Development Lifecycle

The URS is the starting point of the V-model. It sits at the top left, and the validation activities that prove the system works sit directly across on the right. Under FDA design controls (21 CFR 820.30), user needs drive what gets designed, the design is verified against those needs, and the finished product is validated against the original user needs at the end.

The URS must be completed before you select a vendor, define contracts, or begin qualification testing. A URS written after procurement misses the point because it no longer influences the design.

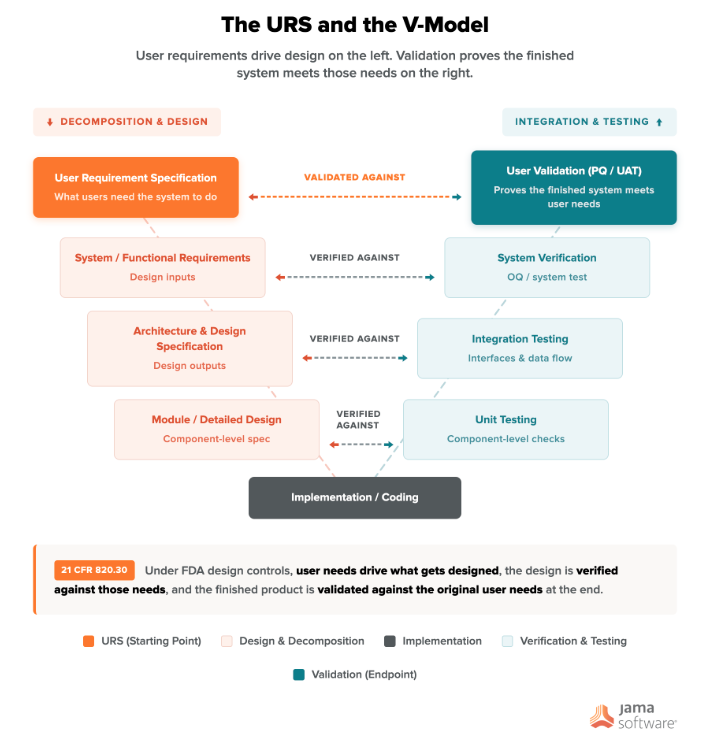

Diagram showing the URS in a V-Model format.

How the URS Differs From an SRS and FRD

The URS, software requirements specification (SRS), and functional requirements document (FRD) sit at different levels. The URS describes the outcome in the user’s language. The SRS defines how the software will work, down to parameter names, error codes, and timing. The FRD describes specific system behaviors tied to a chosen technology.

For example, a URS for an insulin pump might say “prevent bolus doses exceeding the clinician-set maximum.” The SRS would then specify that the software checks each dose against a stored limit, rejects entries over it, and displays an error code within 500 milliseconds. Keeping these layers separate is a compliance requirement under both FDA guidance and the IEEE 29148 standard.

Core Components of a URS

A regulated URS organizes requirements into categories, and each category has its own rules for how you prove the requirement was met. Every requirement needs measurable conditions so it can actually be tested.

Functional Requirements

Functional requirements describe what the system must do: its behaviors, inputs, outputs, and capabilities. Each one describes an action, not the mechanism behind it. In a regulated URS, every functional requirement gets a unique ID and description. It may also get a criticality level that indicates how important it is.

Regulated URS templates commonly use hierarchical codes like UR.F001.01, where the prefix tells you the category and the numbers narrow down to the specific sub-requirement. Any requirement tied to Good Practice (GxP) standards, the umbrella term for quality regulations in pharma and life sciences, gets marked as “MUST” per ISPE GAMP 5 templates.

Non-Functional Requirements

How fast, how available, and how usable a system needs to be is just as auditable as what it does. Non-functional requirements cover quality attributes and operational constraints like response time, uptime, and usability. A user need like “Portable” isn’t testable on its own. You need to turn it into something measurable, like “weighs no more than 5 lbs plus or minus 1 lb.” When non-functional requirements conflict with each other, FDA design controls guidance requires that you resolve and document the tradeoff.

Safety and Regulatory Requirements

Safety requirements describe the conditions the system must meet to prevent harm. They come from hazard analysis, where the team identifies what could go wrong and how severe it would be. The findings from that analysis feed into design inputs, and safety controls that come out of it may be written directly into the URS. Regulatory requirements define the compliance obligations that laws, standards bodies, or regulatory authorities impose on your system. A bioprocess equipment URS, for example, might require that lubricants in contact with process fluid comply with 21 CFR Part 178 and be certified to United States Department of Agriculture (USDA) H1 or equivalent.

Acceptance Criteria

Without a clear pass/fail line, you can’t verify a requirement. Acceptance criteria are the measurable conditions a requirement must satisfy to pass. They have to be objective and set before testing begins.

The FDA is specific about the word “predetermined.” You define what “pass” looks like before you run the test, not after you see the results. A well-formed acceptance criterion covers four elements:

  • Parameter: What the test evaluates.
  • Measurement method: How the team measures the parameter.
  • Pass/fail threshold: The limit that determines success or failure.
  • Test conditions: The conditions under which the result is valid.

Vague acceptance criteria create gaps that show up as audit findings later.

How to Write a User Requirement Specification

Writing a URS that survives regulatory scrutiny follows a sequence. Gather needs broadly, write at the right level, make every requirement testable, then lock the document through formal review.

1. Gather Needs From All Contributing Teams

Requirements elicitation, the process of gathering what stakeholders actually need, requires input from every group that touches the system. A URS written by a single engineer and rubber-stamped by management is a documented failure mode. Common contributor groups include:

  • Production and operations staff: Define how the system needs to work in daily use.
  • Quality assurance leads: Review for compliance needs and validation expectations.
  • Engineering and maintenance teams: Contribute technical constraints and serviceability needs.
  • IT and systems engineering groups: Provide input on how the system fits into the broader environment.
  • Regulatory affairs: Identify compliance obligations that must appear in the URS.
  • Suppliers: Provide constraints or interface needs that affect the final requirements.

The more complex or risky the system, the more deeply each group should be involved.

2. Write at the User Level, Not the Solution Level

If a developer reads a requirement and has zero design freedom because the requirement already specifies the solution, it’s written at the wrong level. A good format to follow: [who] shall [do what] [to what] [under what conditions]. The word “shall” signals a binding requirement. Each requirement should contain one statement per sentence, use active voice, and avoid stacking multiple conditions into one clause.

“The aircraft shall have three engines” prescribes a design. “The aircraft shall meet the operation requirements with a single engine out” defines a capability and leaves the design team free to determine how to achieve it.

3. Make Each Requirement Testable and Unambiguous

Every requirement should be necessary, appropriate, unambiguous, complete, and singular. Those quality checks come from INCOSE’s Guide to Writing Requirements, a widely used reference for writing testable requirements. Vague terms like “fast,” “easy,” or “user-friendly” fail because they can’t be measured or tested consistently.

The Easy Approach to Requirements Syntax (EARS) gives you sentence templates that turn vague language into testable statements. An ambiguous requirement like “the system should handle errors” becomes testable when rewritten as “If the radar fails, then the cruise control system shall enter standby mode.”

4. Obtain Formal Review and Sign-Off

Cross-functional review is the last checkpoint before the URS is locked in as the baseline. Reviewers check three things: every requirement traces back to a real stated need, acceptance criteria are defined for each requirement, and the URS as a whole reflects actual operational needs. Once the document is signed off, any changes require formal approval, a documented impact assessment, and an updated version number.

Managing the URS in Regulated Industries

Once approved and baselined, the URS becomes the reference point for configuration management, traceability, and validation. Every change to a baselined requirement ripples downstream. Design documents, test protocols, and risk assessments that link to that requirement all need to be reviewed.

Maintaining Bidirectional Traceability

Bidirectional traceability is a core expectation in regulated work. Forward traceability means you can follow a requirement from the URS through design and into testing. Most teams build this naturally. Backward traceability means you can start at any test and trace it back through design to the original requirement. Reviewers use backward tracing to confirm that no test exists without a corresponding requirement and no requirement exists without evidence that it was verified.

Requirements that don’t apply still need to be called out, justified, and recorded in the traceability matrix. If a requirement is silently absent from the matrix, a reviewer can’t tell whether it was intentionally excluded or accidentally missed.

Controlling Post-Baseline Changes

Once the baseline is set, you can’t just edit the document. Every change goes through formal change control. Each approved URS change triggers updates across four areas:

  • Traceability matrix: The matrix must reflect the revised requirement and its links.
  • Risk assessment: Linked risk assessments need re-evaluation.
  • Test protocols: Affected protocols must be updated and re-executed where needed.
  • SOPs and training: Standard operating procedures and training materials tied to changed requirements must be revised.

Skip any one of these downstream updates, and you’ve created a gap. Auditors treat it the same way they treat a missing requirement. The traceability chain is broken either way.

How Jama Connect Supports URS Management

Jama Connect® is a requirements management platform that keeps URS requirements, design elements, test cases, and risk items connected in a single system. When you manage a URS manually across spreadsheets and shared drives, things break down as projects grow. A requirement changes in one file, but the linked test protocol in another file doesn’t get updated, and nobody notices until an auditor pulls the thread.

With Jama Connect, suspect-link flags automatically tell downstream owners exactly what needs review the moment something changes. Teams can see the full trace from any URS requirement through to its design output, verification activity, and risk assessment. That visibility means you catch gaps in real time instead of scrambling to reconstruct traceability before an audit or submission deadline.

Turning URS Compliance Into a Continuous Workflow

The hardest part of URS management isn’t writing the initial document. It’s keeping everything downstream, design documents, test protocols, risk assessments, aligned as requirements change due to design updates, new regulations, or risk findings that surface after the baseline is set. Teams that build traceability into their daily workflow, connecting every requirement to design evidence and reviewing downstream artifacts whenever something changes, spend less time preparing for audits and more time building. Start a free 30-day trial of Jama Connect to see how it fits your process.

Frequently Asked Questions About User Requirement Specification (URS)

What is the difference between a URS and an SRS?

A URS describes what users need the system to do, in their language, without specifying how the software should work. An SRS translates those user-level needs into software-specific detail: parameter names, error codes, timing constraints, and testable thresholds. Both are required in regulated development, but the URS must exist first because it defines the acceptance criteria that validation ultimately confirms.

Who is responsible for writing a URS?

No single role owns the URS. The system or equipment owner typically leads the writing. End users define functional and operational requirements. Quality assurance reviews for regulatory compliance and gives final approval. Engineering provides input on what’s technically feasible. The more complex or risky the system, the more deeply each group should be involved.

How detailed should a URS be?

Detailed enough that every requirement is testable and unambiguous, but not so detailed that it prescribes the solution. GAMP 5 helps you calibrate the right level of detail based on risk, complexity, and how new the system is. For custom software (Category 4 and 5 systems in GAMP terms), requirements should be developed without assuming a specific solution. Requirements related to patient safety, product quality, and data integrity should always be specified, no matter what category the system falls into.

Does a URS need to be updated after a project begins?

Yes, but only through formal change control. The URS should stay current throughout development because design, testing, and validation all trace back to it. Once it’s baselined, adding, deleting, or modifying any requirement requires formal approval, a documented assessment of what the change affects downstream, and an updated version number. Jama Connect automates the impact assessment step by flagging every linked artifact when a baselined requirement changes.
